Platinum Park Estate – Phase 3




October 2021


Stand allocations of the 153 Residential stands in this the 3rd Phase to our Top Structure Developers has been successfully undertaken with sales of building packages progressing extremely well

October 2022


After a lengthy 12 month wait for the City of Tshwane’s final approvals, the installation of the township civil services commenced with completion expected March 2023

November 2022

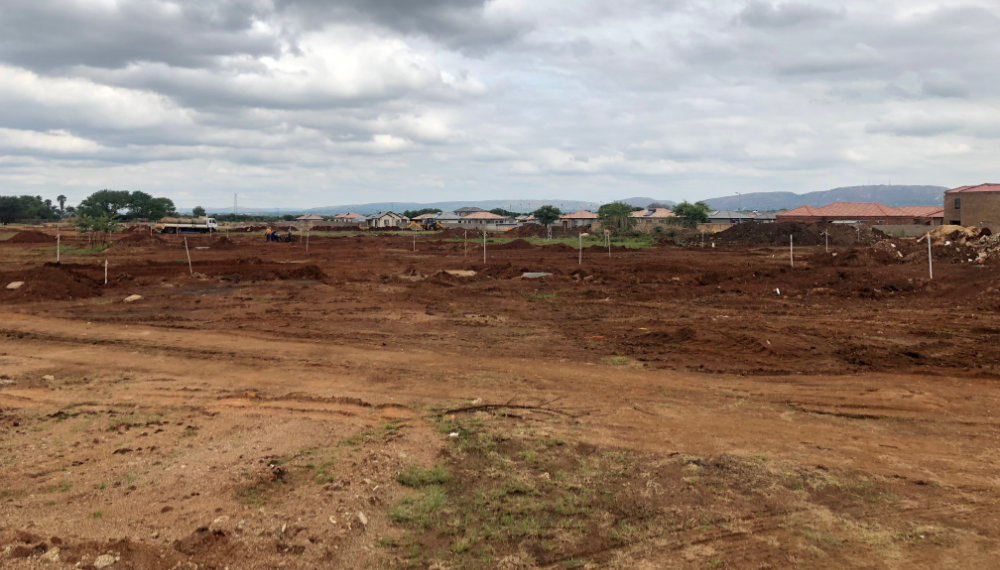

With the civil services complete, box cutting of internal roads well underway

Klerksoord Extension 30
Klerksoord Extension 30


Completion of the external Stormwater upgrade nearing completion

Klerksoord Extension 30
Klerksoord Extension 30


January 2023

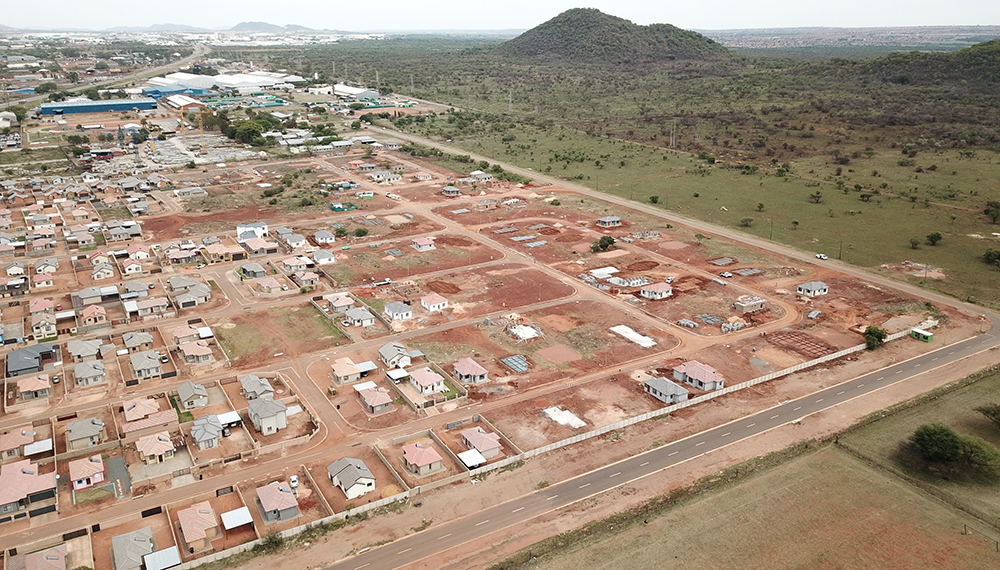

Road bedding nearing completion in preparation for black top application in March 2023

Klerksoord Extension 30
Klerksoord Extension 30
Klerksoord Extension 30


November 2023

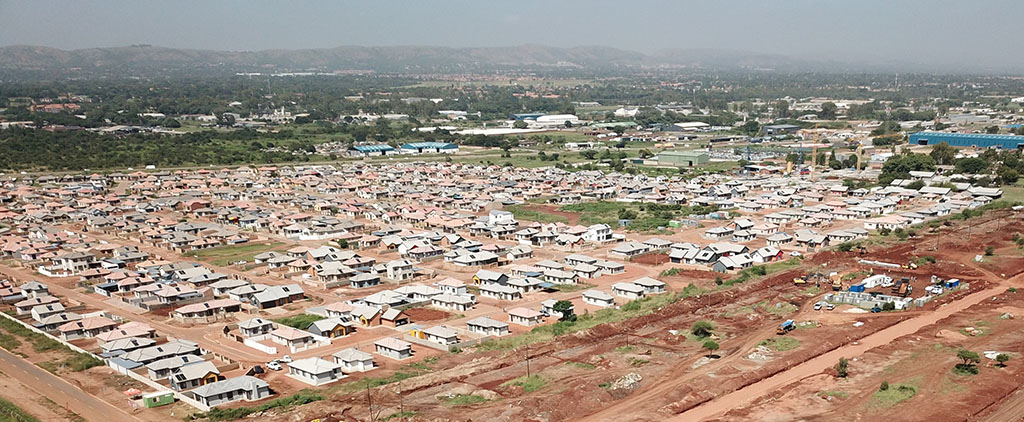

With Proclamation of the township in October 2023, well over 50% of the 120 stands registered have houses either under construction or completed

Klerksoord Extension 30
Klerksoord Extension 30


Mid 2024


The township is successfully sold out and construction of all 153 houses are completed

Klerksoord Extension 30
