Platinum Park Estate – Phase 1





We have secured the Platinum Park Estate project, which consists of four extensions yielding a total of 700 residential stands

The property is located 3kms east of the Rosslyn Hub along the R566 and is easily accessible from the N4 and R80 freeways

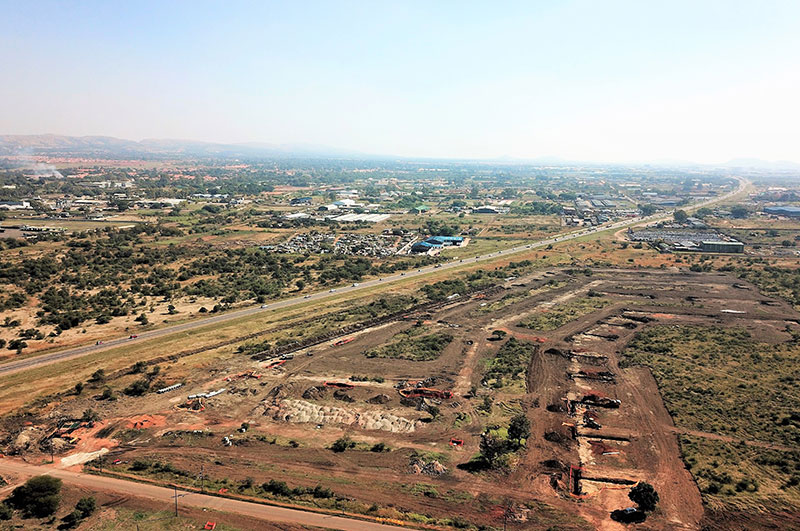

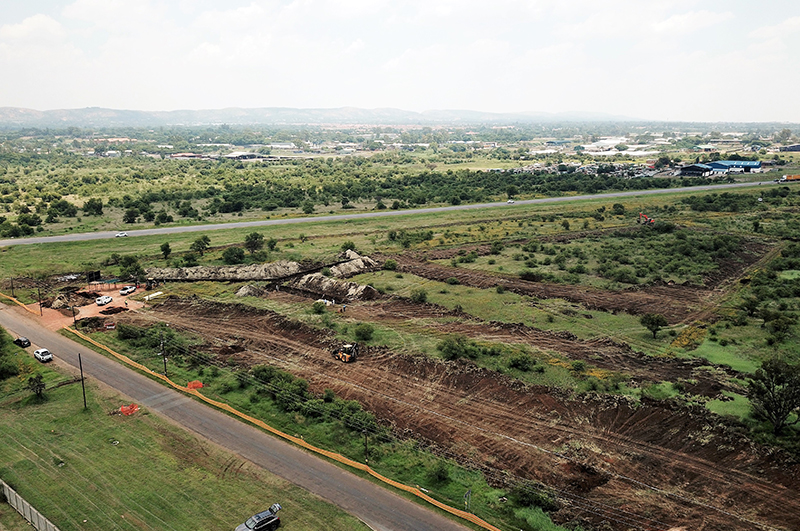

Construction on the first phase, Extension 28 (consisting of 184 stands) started in January 2019 with the installation of civil and electrical services


JANUARY 2019

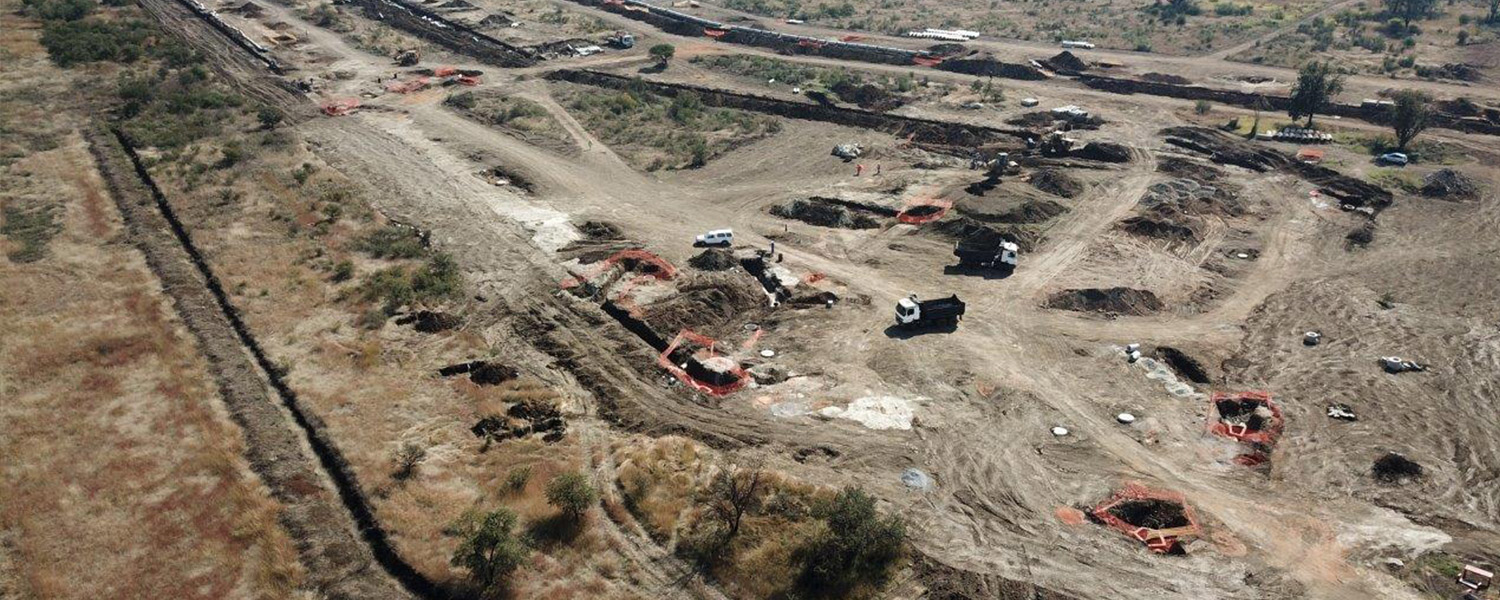

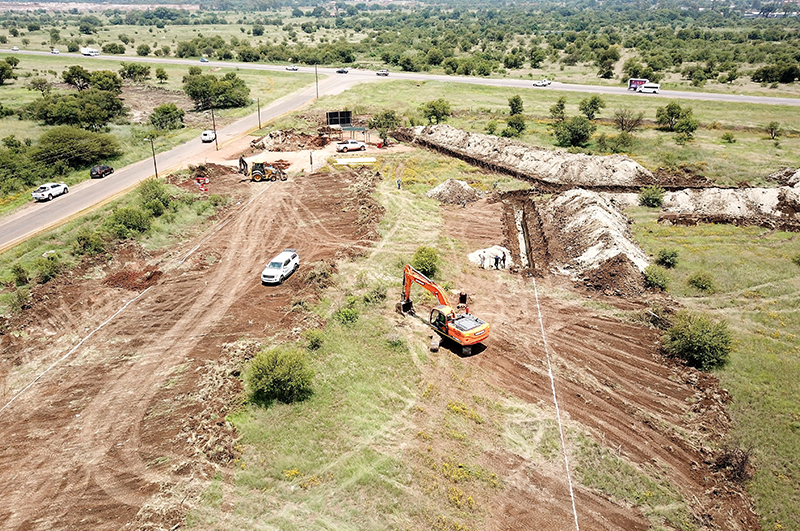

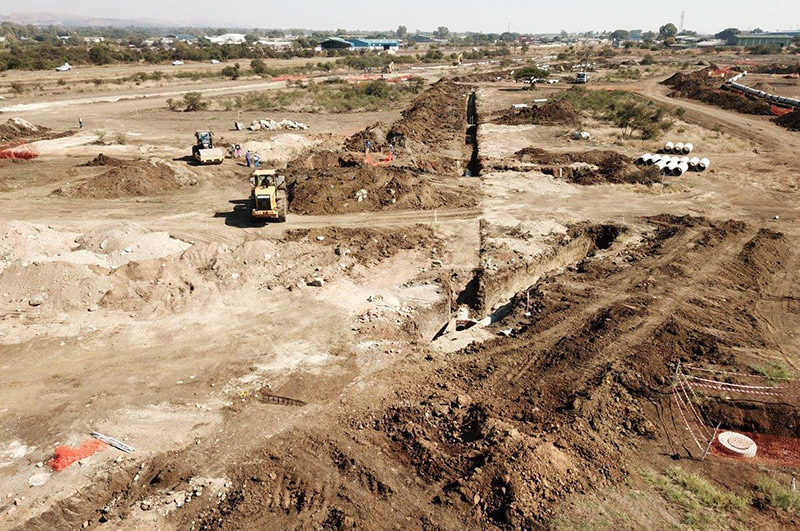

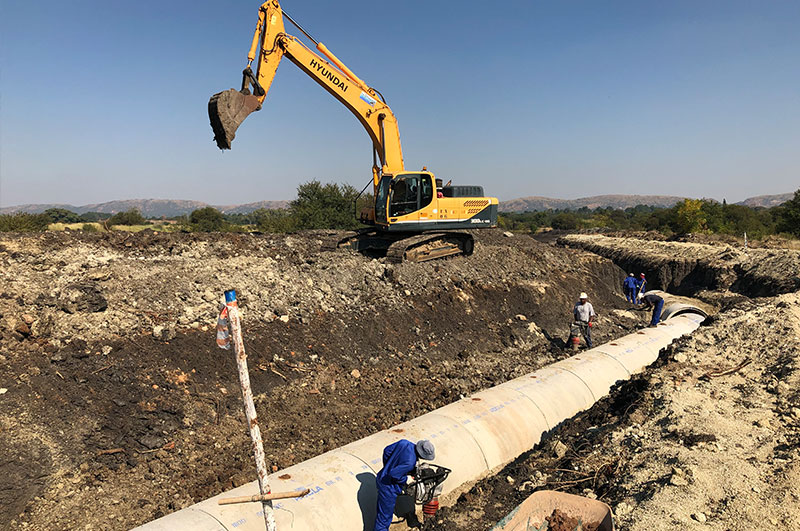

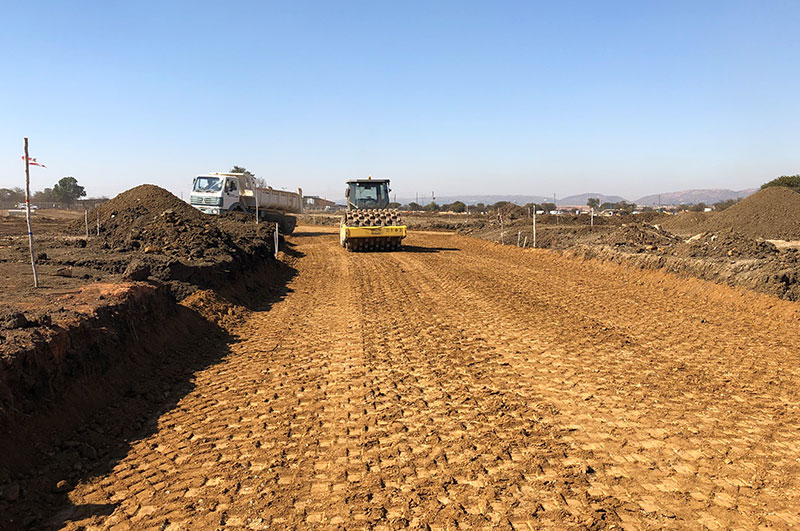

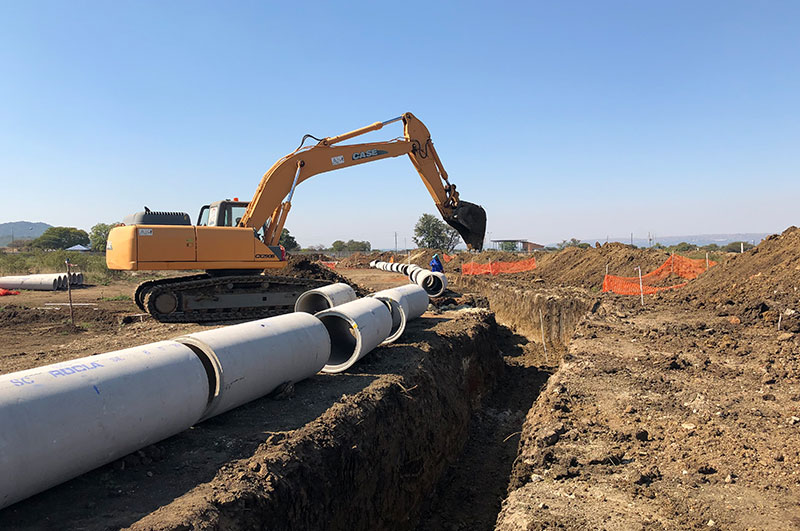

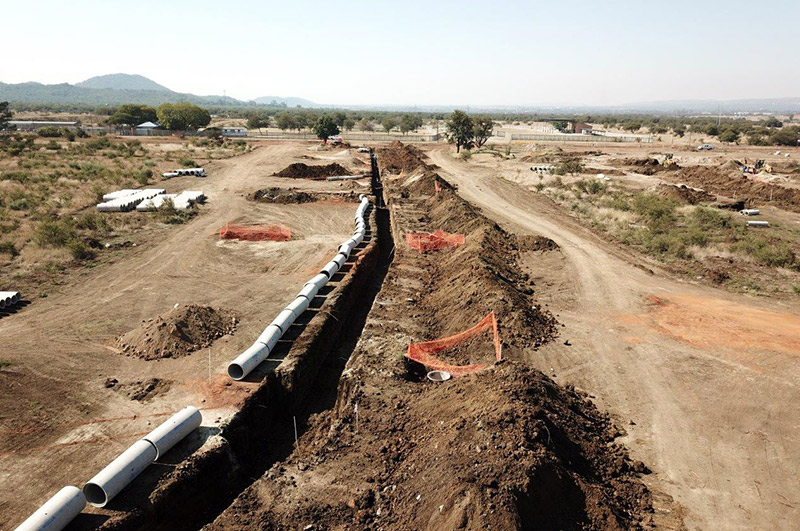

Commencement of the installation of the Internal & External Civil Stormwater and Sewer reticulation

Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)

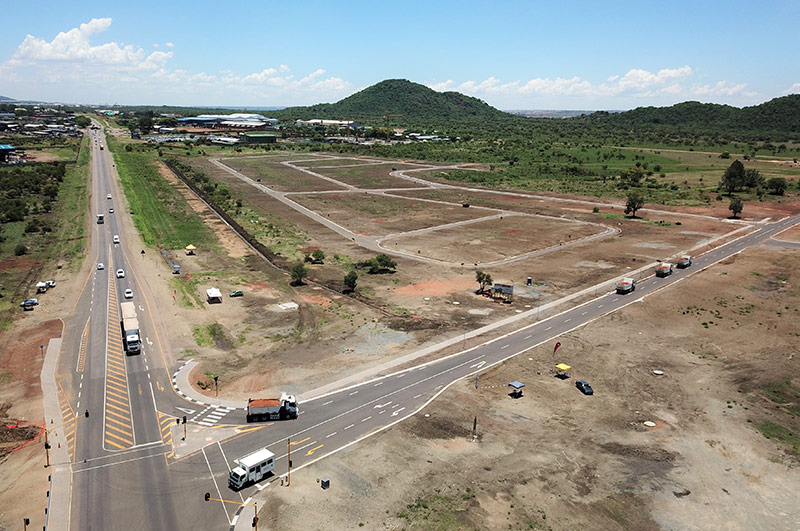

FEBRUARY - JUNE 2019

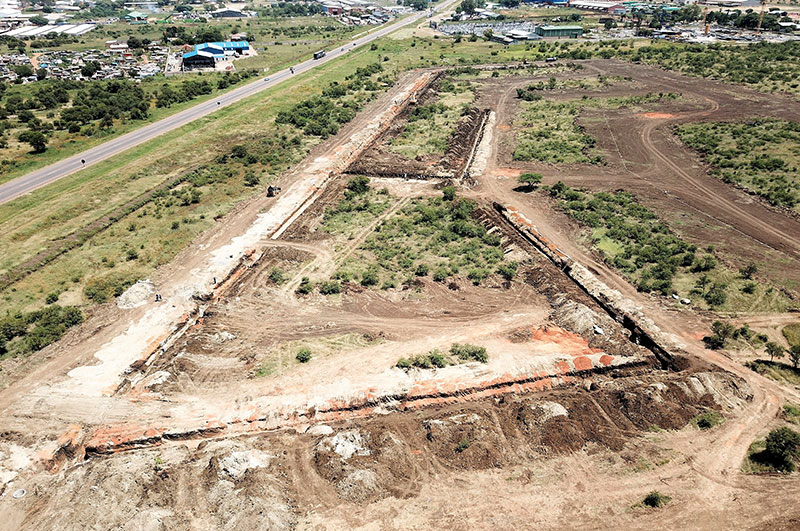

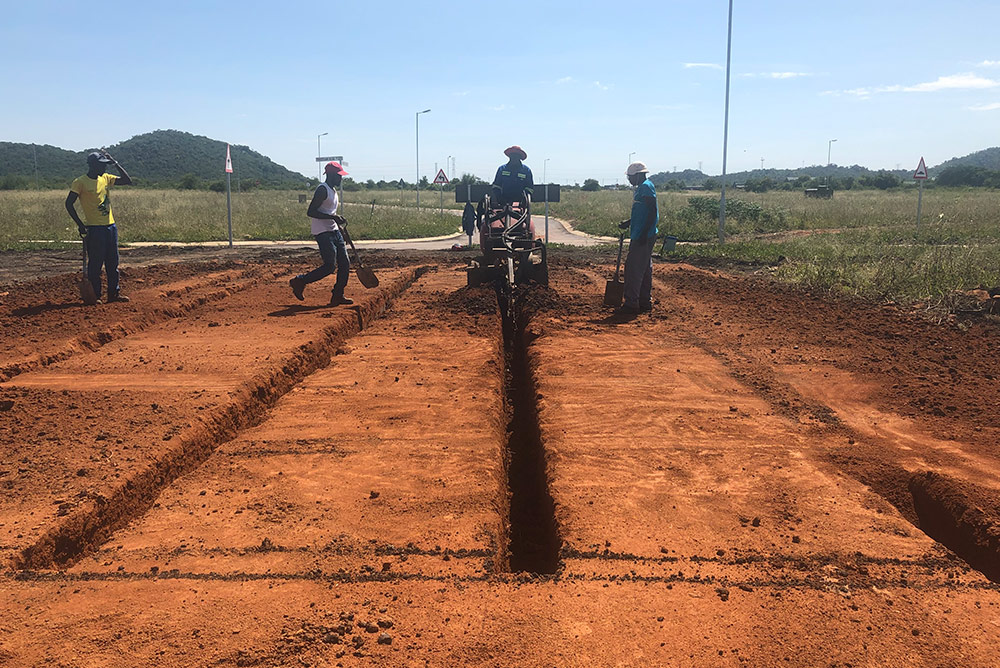

Progressing well with the installation of the Internal Water, Sewer & Stormwater reticulation. Box cutting of internal Road infrastructure commences

Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)

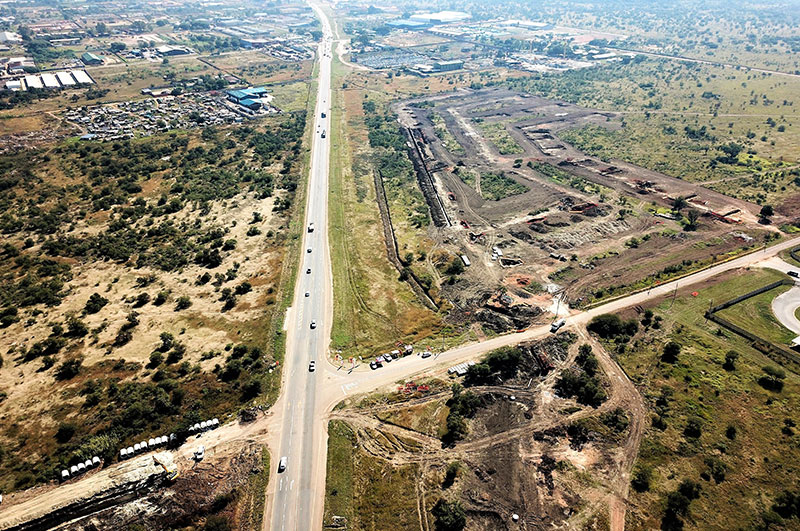

JULY 2019

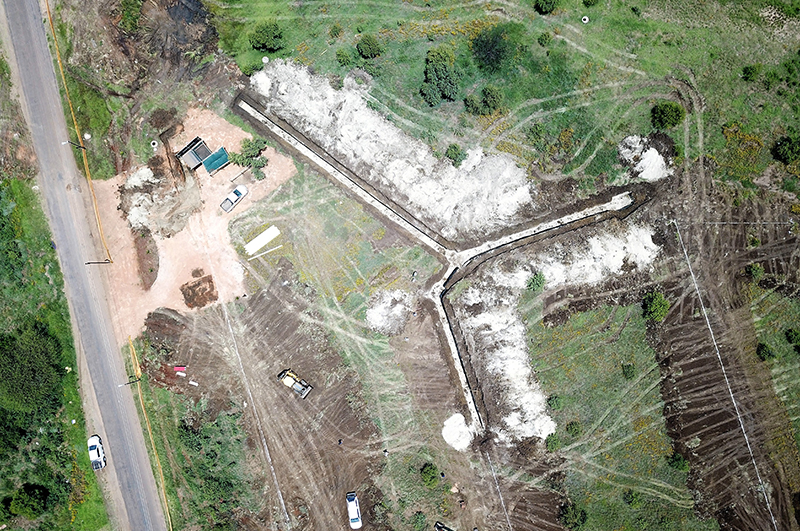

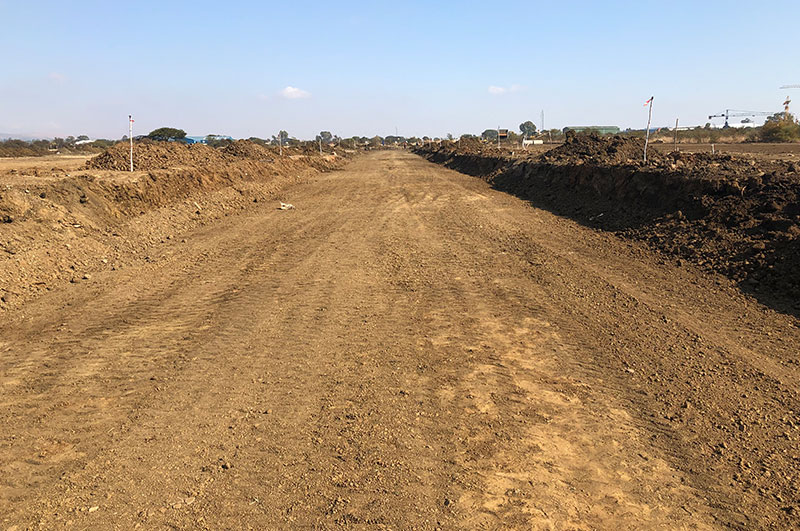

Closing up of the internal Stormwater, Water, Sewer & Electrical conduiting reticulation. Preparation of Internal Road-bed infrastructure commences


Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)

AUGUST 2019

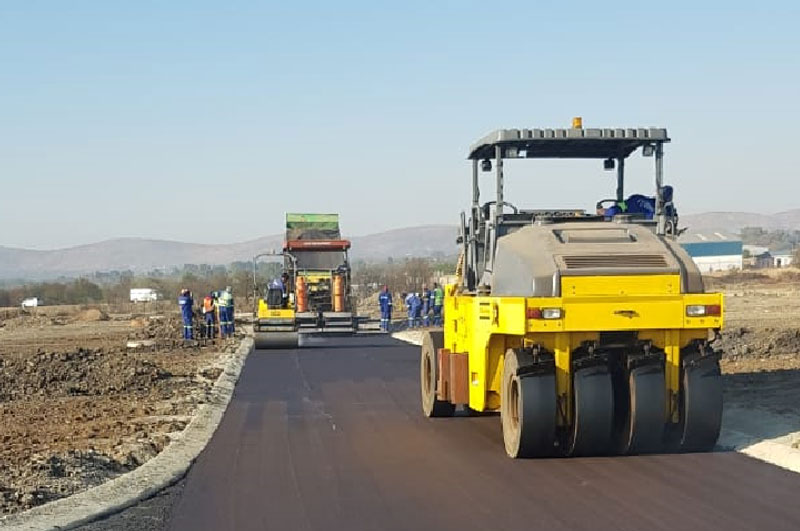

Preparation of the Road infrastructure for the tarring process

Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)

OCTOBER 2019

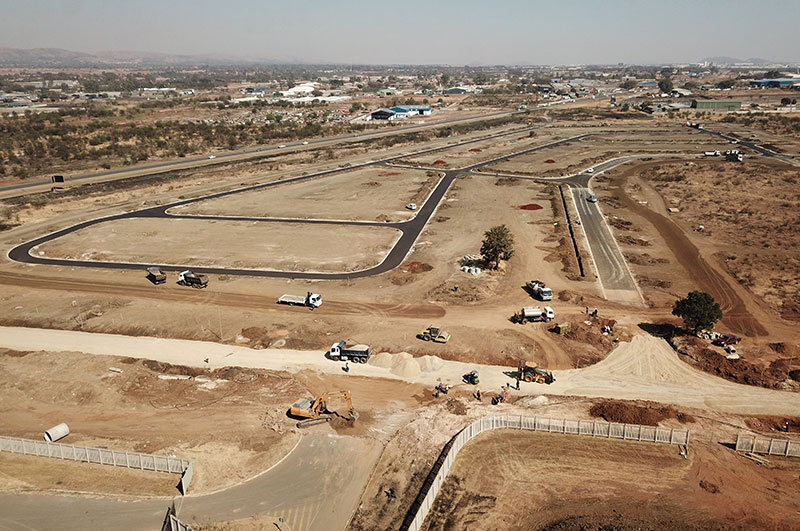

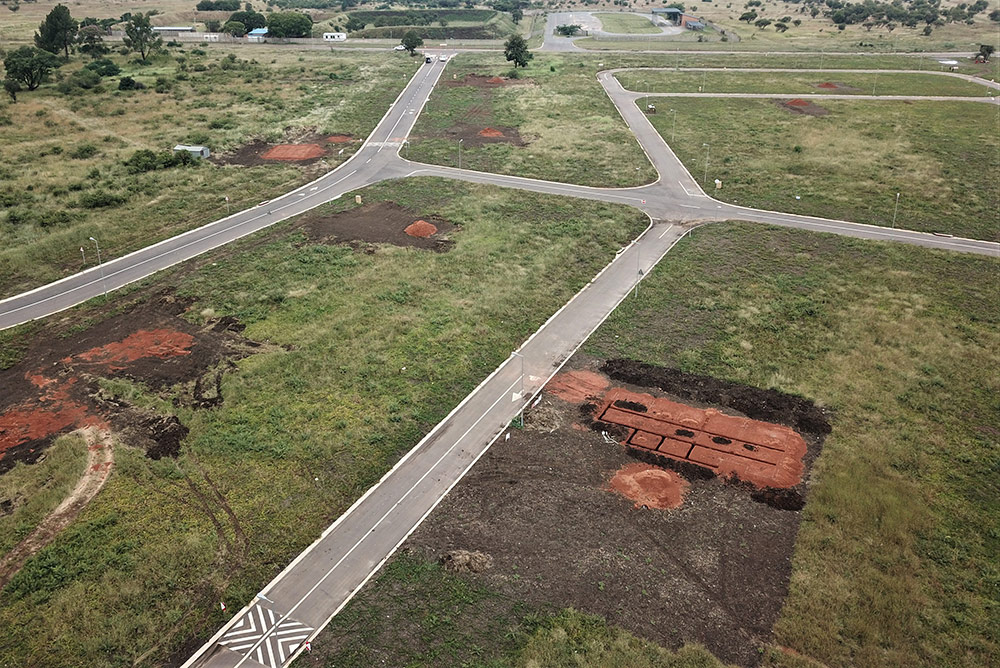

Internal Civil reticulation & Road infrastructure of 184 Residential stands completed together with the upgrading of the external Stormwater, Sewer, Water & Road infrastructure

Klerksoord Extension 28 (36,5Ha)

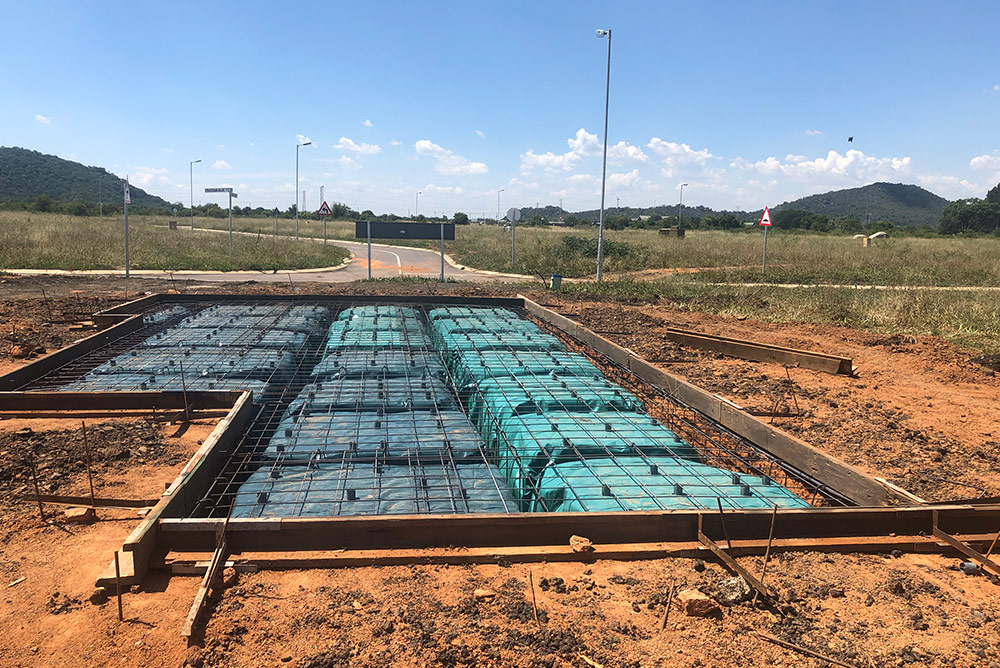

FEBRUARY 2020

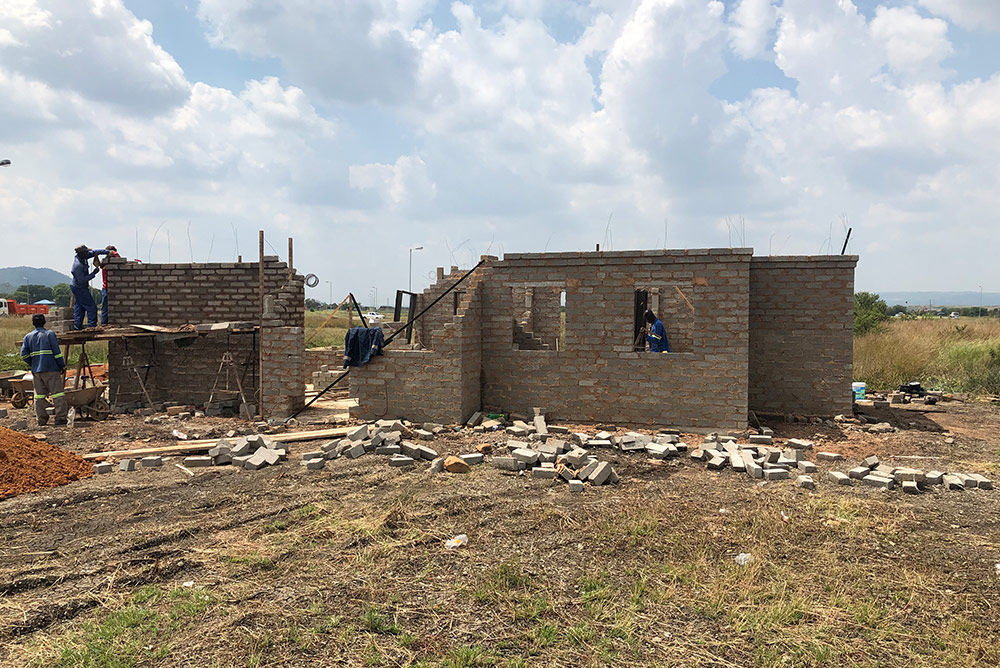

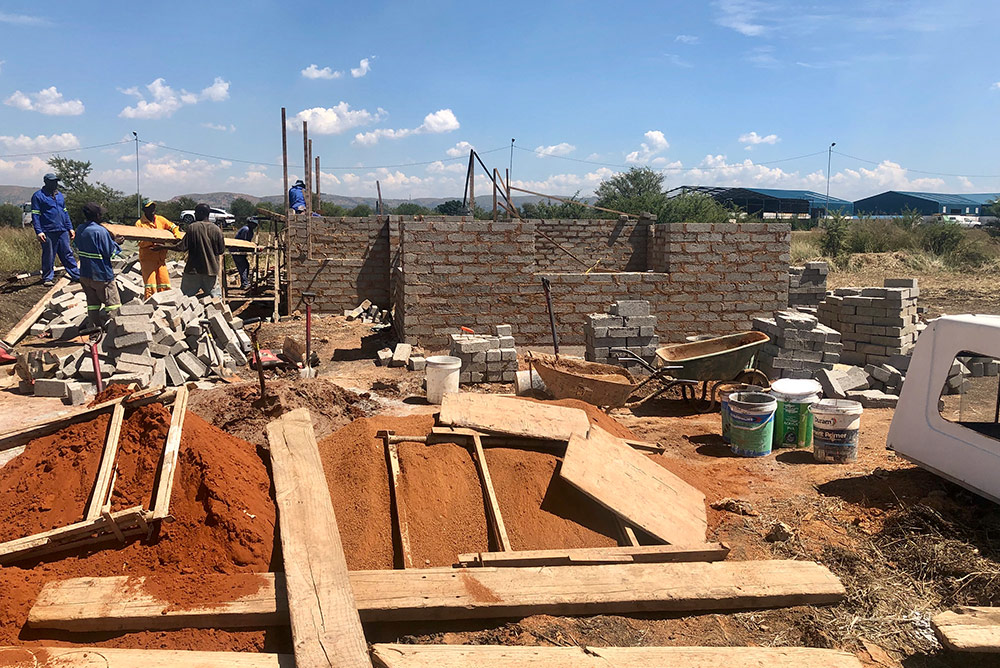

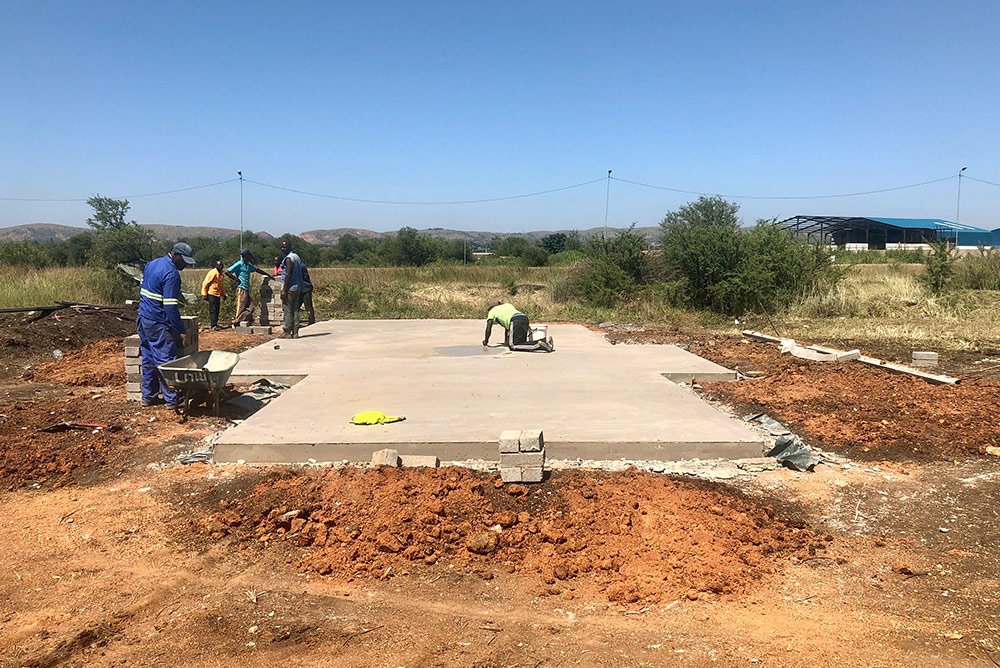

Construction of the first 20 houses by our Top Structure Developers commences with the preparation of raft foundations, floor slabs and then super structure and roofs

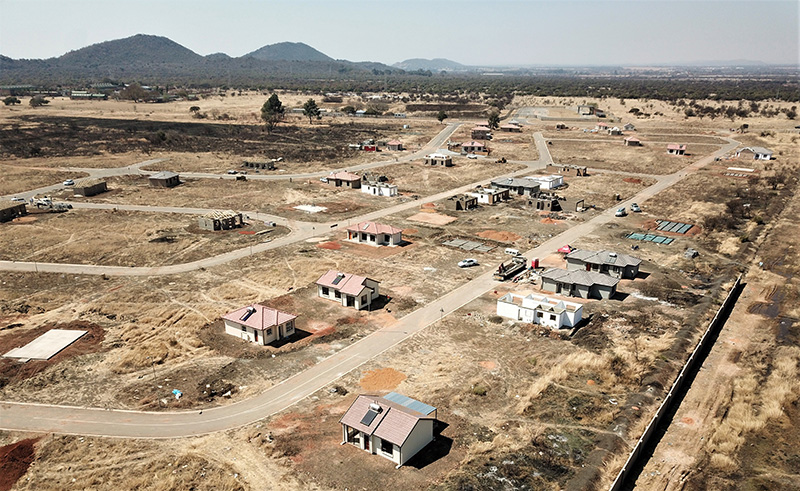

Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)


June 2020

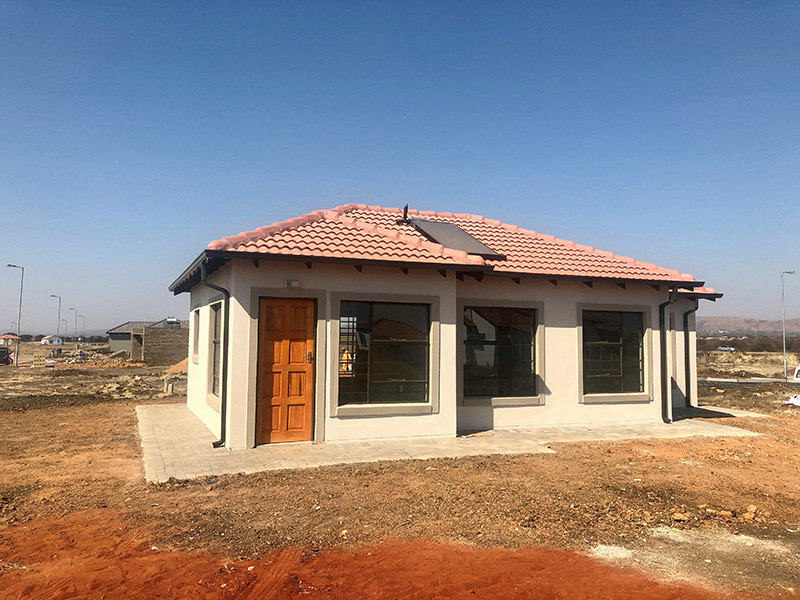

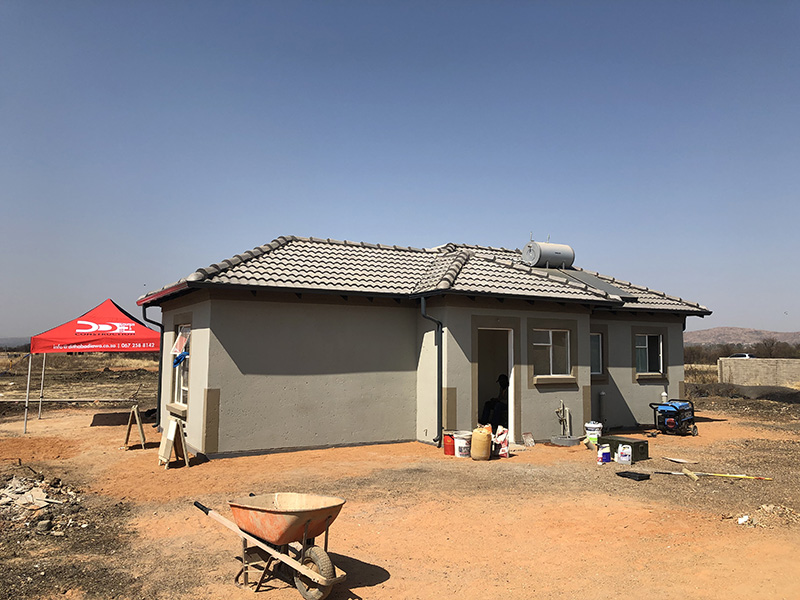

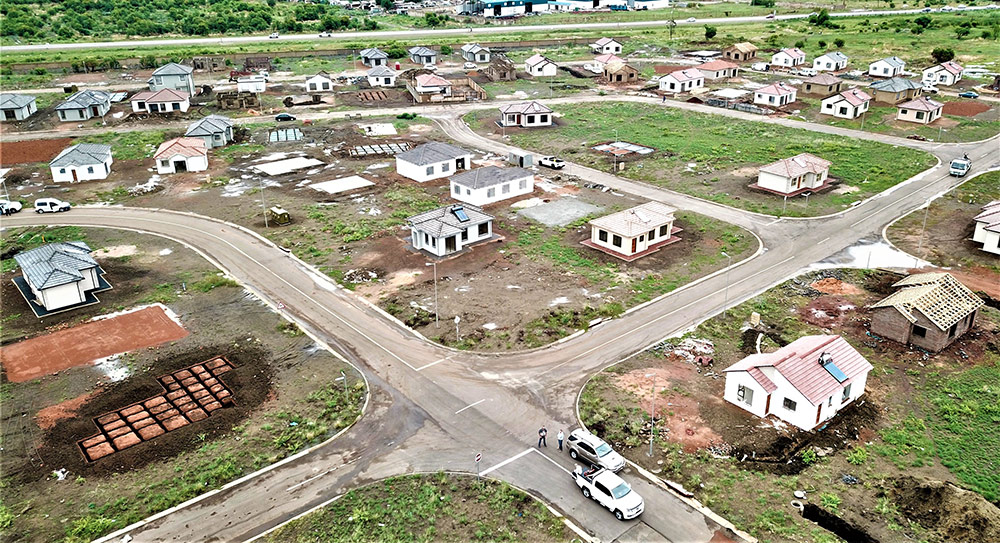

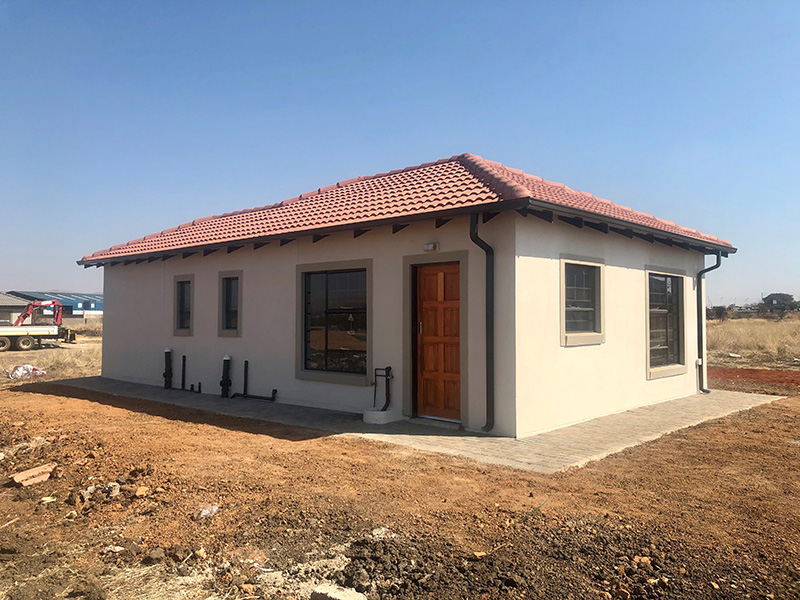

Construction of houses could continue again after lockdown restrictions were eased resulting in the first houses being completed

Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)

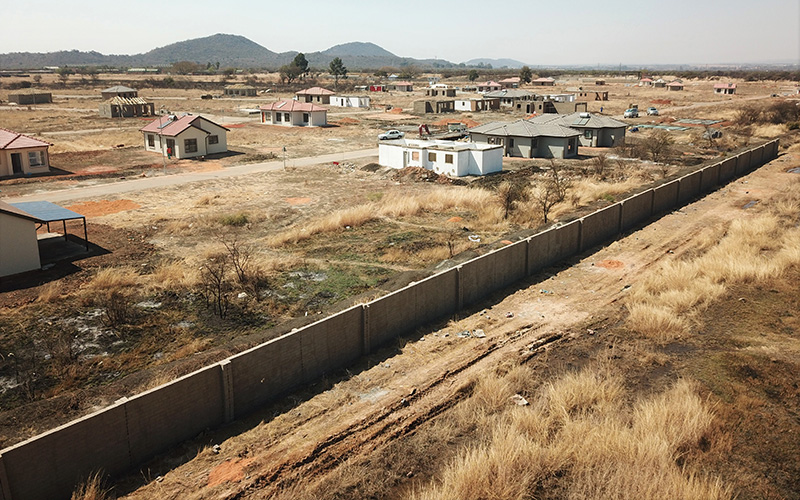

August 2020

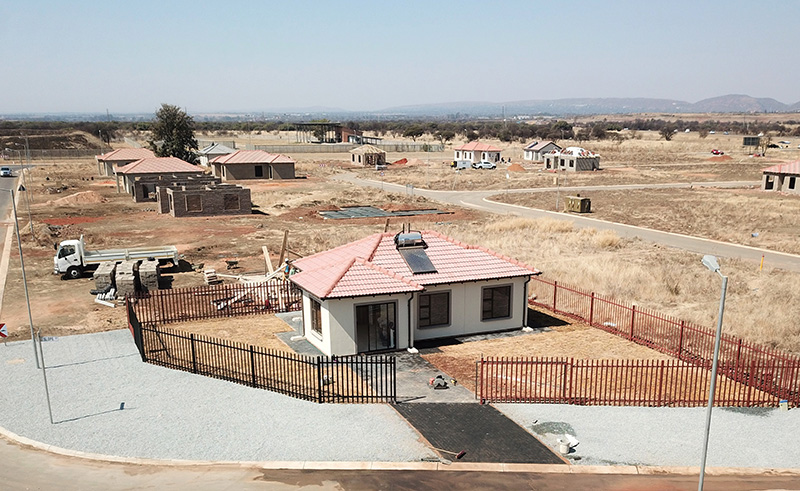

Construction of the 2m high Perimeter Security Wall commenced with in excess of 70 houses either under construction or completed

Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)
Klerksoord Extension 28 (36,5Ha)


September 2020


Phase 1 of Platinum Park Estate is SOLD OUT!

Klerksoord Extension 28 (36,5Ha)


September 2021

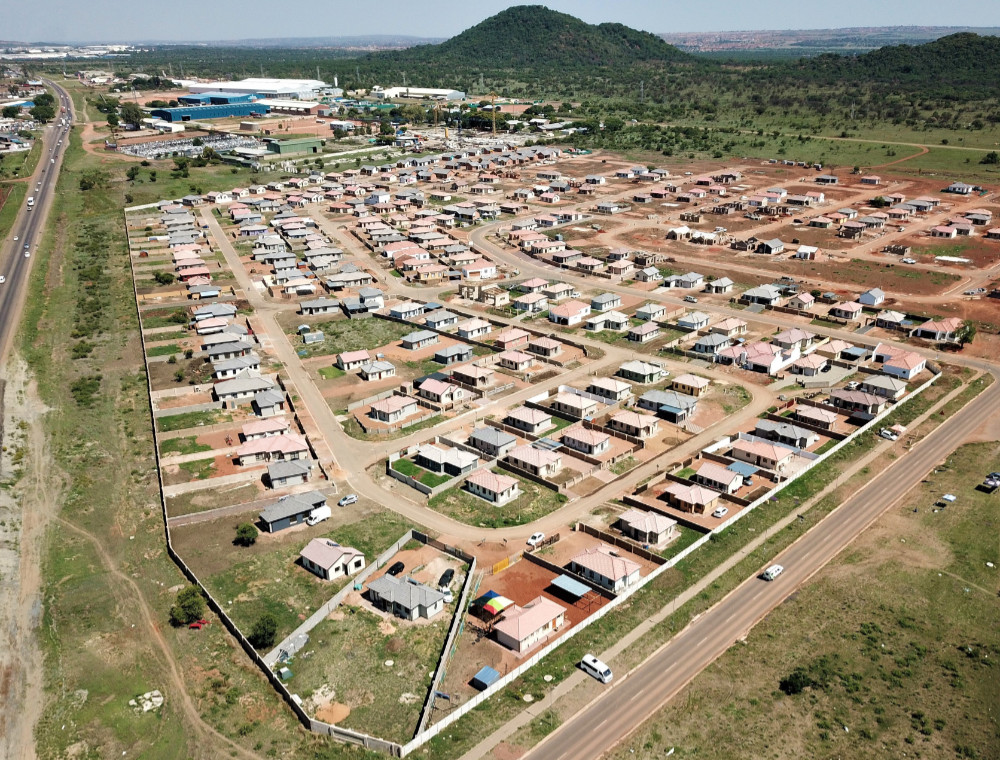

Construction of all 184 houses completed in Phase 1

Klerksoord Extension 28 (36,5Ha)
